You can use one or more of the following nodes for your pipelines. These modeling nodes are listed in the Nodes pane on the left of the Pipelines tab. They are also available as templates in The Exchange.
Some modeling nodes provided by SAS Visual Forecasting are pluggable. These nodes provide a code editor that you can use to customize the node settings. After running a pipeline, any change to the code or right pane settings for a modeling node requires the pipeline to be run again.
When a project is imported or upgraded from a prior release, the pluggable modeling nodes in the pipeline are not upgraded in order to prevent overwriting any customizations that might have been made in the code for the node. Often, the node does not require an upgrade in order to work for a new release. If you notice any errors in the node after an upgrade, you can add the node again to the pipeline from The Exchange. The new node can include new features, such as new node options. Then you can add modifications to the code for the new node before you remove the node from the previous release. When you modify the code for the node, use extra caution, because you might inadvertently invalidate some features of the node.
The following modeling nodes are pluggable.
This node models each time seriesan aggregation of transactional data into specified time intervals and sorted according to unique combinations of the default attributes (BY variables) based on the models that you select (ARIMAX, ESM, IDM, UCM). For each time series, the Auto-forecasting node performs the following tasks.
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
For a complete description of the settings for Auto-forecasting, see Auto-forecasting Settings.
This node works only with external forecasta numerical prediction of a future value for a specified time period for each unique combination of BY variable values projects. It cannot be added to the pipeline for projects created from any other type of data source. External forecast projects can use only External Forecasts in the pipeline.
Use External Forecasts in a pipeline to generate the summary statistics and to work with overrides in the forecast horizonthe number of intervals into the future, beyond a base date, for which analyses and predictions are made.. For more information, see Working with External Forecast Projects.
For each time series, the Hierarchical Forecasting node performs the following tasks.
To use this modeling node, you need at least one BY variable assigned.
For a complete description of the settings for Hierarchical Forecasting, see Hierarchical Forecasting Settings .
The Hierarchical Forecasting (Pluggable) node provides similar functionality as the Hierarchical Forecasting node. Here are the main differences:
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
The results for this node are expected to be the same as those of the Hierarchical Forecasting node when both nodes are run with the default settings.
The Hierarchical Modeling node is used to provide in-depth modeling and analysis at each level in the project hierarchythe order of the variables that you have assigned to the BY variables role. An example of a hierarchy is Region > Product Category > Product Line. . After the Data node is run, you can open this node to access the pipelines for each level in the project hierarchy, enabling you to add multiple models, perform interactive modeling, view plots, and save output data sets at each level. The project hierarchy is defined by the BY variable assignment on the Data tab.
If you add a pipeline template that contains a Hierarchical Modeling node to a nested pipeline (External Segmentation or Demand Classification), the Hierarchical Modeling node fails when the nested pipeline is run.
This node is not a pluggable model. The code used for this node cannot be edited. If you download this node, it does not include the code to create the node.
The Copy pipeline link action is not available for nested pipelines. For more information, see Copy pipeline link.
After the Data node is run, right-click this node and select Open to view the Hierarchy Levels table. The Name column shows the hierarchy levels along with the TOP level of the hierarchy. If a hierarchy is not defined, only Top is shown. Each row is a level in the hierarchy with its own nested pipeline that you can open, customize, and run.
After the node is run, reconciliation is performed. The success of the reconciliation is indicated above the table to the left. When reconciliation is running, you cannot open any of the nested pipelines in the table.
Sometimes the pre-reconciled predicted values can have missing values in the historical region due to lags used in modeling. During reconciliation, those missing values are filled with actual values. This adjustment causes a small difference between the weighted statistics of the pre-reconciled and reconciled forecasts at the reconciliation level.
The following controls are above the table to the right:
The following icons perform actions that you can also select when you right-click a hierarchy level. If a level is not selected, these icons are disabled.
You can customize this nested pipeline like any other pipeline, with the exception that you cannot add a Hierarchical Forecasting, Hierarchical Forecasting (Pluggable), or another Hierarchical Modeling node to the nested pipeline.
Use this option if there is a failure in the hierarchy reconciliation.
Each pipeline is assigned using the
Default pipeline setting for the Hierarchical
Modeling node. If the value is changed after running the pipeline, it does not
change the assigned pipeline for each level. To change the assigned pipeline to the
new
default setting, select one or more levels and click .
After successfully running the pipelines, if
you reset the default pipeline, the modeling node and the following nodes show a status
of
Out-of-date. If you open the modeling node, the
individual levels show a status of Completed.
However, the nodes that are Out-of-date should be
run again.
Use the following settings to make changes to the reconciliation for this node.
The reconciliation level is specified for this node by selecting a BY variable from the hierarchy. Consider the order of the default attributes (BY variables) defined on the Data tab. Select a variable to determine the type of reconciliation methodthe method that specifies the level in the hierarchy where the process of reconciliation starts. The following reconciliation methods are available: bottom-up method, middle-out method, and top-down method. .
Location at the top and Name at the
bottom, select Name to perform bottom-up reconciliation.High,
Medium, and Low (with
High at the top), specify Medium to generate
forecasts for that level and then reconcile forecasts for the upper and lower levels
in the
hierarchy.By default, the reconciliation level set on the Data tab for the BY variables is used.
For a description of top-down, middle-out, and bottom-up reconciliation methods, see Understanding Hierarchy Reconciliation.
specifies the type of disaggregation methoda method that specifies how the forecasts in the lower level of the hierarchy are reconciled when the reconciliation method is top-down or middle-out. The disaggregation method can reconcile the forecasts in either of the following ways: (1) by using the proportion that each lower-level forecast contributes to the higher-level forecast; or (2) by splitting equally the difference between the higher-level forecast and the lower-level forecasts. and type of loss function for top-down reconciliation. Select one of the following methods for top-down disaggregation:
Hierarchical Modeling automatically generates these tables. You can use the Save Data Node if you need to save any of these tables. You can add other models to the nested pipelines to generate other tables for any level in the hierarchy.
For Hierarchical Modeling, you can save the Statistics of Fit (OUTSTAT), Model Attributes (OUTMODELINFO), Forecasted Values (OUTFOR), , and Model Forecasts (OUTFOR_MODEL) tables for each level in the hierarchy.
The Naive Model node uses one of the naive models that you select to generate forecasts for each time series.
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
The following settings are available in the Options pane for the Naive Model node.
Select from the following.
For this option, indicate the size of the moving average window.
For this option, specify if you want the drift option.
For this option, specify if you want the drift option.
If you choose a Random walk or Seasonal random walk model, you can add the drift option.
Specify an integer, greater than 1, for the window size for the moving average model.
Naive Model automatically generates these tables. You can use the Save Data Node if you need to save any of these tables.
You can select the following optional tables. Select any tables that you want generated when this node is run. After the node is run, the tables can be saved using the Save Data Node.
The Naive Model does not support events.
For any time series with fewer than six nonmissing observations, an ESM model (ESM BEST) is used instead.
The Distributed Open Source Code node enables model developers, such as statisticians, data scientists, and forecasters, to provide their own open source code to perform time series forecasting for a project. When this node is added to a pipeline, it is not ready to run until the code has been added by the developer. SAS Visual Forecasting supports open source code written in R or Python.
The Distributed Open Source Code requires a deployment that contains a properly configured EXTLANG package. If the developer does not have the necessary access control permissions that are required by the EXTLANG package, the code does not work. For additional instructions, see External Languages Access Control Configuration. In addition, users who are running Distributed Open Source Node must be added to the CASHostAccountRequired custom group. For more information, see The CASHostAccountRequired Custom Group.
Once the environment is set up, the developer can follow these steps to add the code and run it.
The VF_PREDICT variable must be populated with the predictions from the open source code.
When the node completes, check the following sources:
After the code is included and has been run successfully, you can rename the node and save it to The Exchange for use in any other pipeline or project. You can add an Interactive Modeling node after it and compare the model comparison criteria with other models.
The Distributed Open Source Code internally constructs a program, referred to as the bridge program, which runs the timeData.runTimeCode action to execute various methods of the EXTLANG package. For more information, see the EXTLANG package documentation at External Languages Package. This bridge program interacts with the open source using shared variables.
After selecting the Distributed Open Source
Code in a pipeline, click the Open button in the right pane to
open the code editor. Then click to get a list of these variables.
The following variables are used by the open source code to return data to the bridge program for the Distributed Open Source Code node. The VF_PREDICT variable is required for the open source code. The program optionally can supply VF_ERROR, VF_LOWER, VF_UPPER, and VF_STD corresponding to the forecasts. If these arrays are valid, they appear in the OUTFOR table. Otherwise, the arrays are computed by the bridge program and a note is added to the OUTLOG table listing the array that is not feasible.
All of these arrays must be a length of VF_LENGTH - VF_BACK.
|
Data Item |
Description |
Python Data Type |
R Data Type |
Length |
|---|---|---|---|---|
|
VF_PREDICT |
Array of predicted values computed by the program. The node fails if this is not provided. |
numpy.ndarray or list (footnote 1) |
atomic vector of double |
VF_LENGTH - VF_BACK |
|
VF_ERROR |
Array of variable values computed by the program. If the open source code does not generate this data and provide it in this variable, the bridge program for the node computes the errors for each predicted value. |
|||
|
VF_LOWER |
Array of lower confidence limits computed by the program. If the confidence limits are not generated by the open source code, the bridge program for the node generates the confidence limits. |
|||
|
VF_UPPER |
Array of upper confidence limits computed by the program. If the confidence limits are not generated by the open source code, the bridge program for the node generates the confidence limits |
|||
|
VF_STD |
Array of prediction standard errors computed by the program. If the prediction standard errors is not generated by the open source code, the bridge program for the node generates the prediction standard errors. |
The following variables can be queried by the open source code to obtain information about the project and settings that can be used in generating the forecasts.
|
Data Item |
Description |
Python Data Type |
R Data Type |
Length |
|---|---|---|---|---|
|
VF_BACK |
Number of data points to exclude from modeling. This is set to zero by default. If the user specifies an integer for Number of periods to exclude from modeling in the project settings, the open source code can use this number to remove the time periods from historical data and include it in the horizon. See Assessing the Accuracy of the Models for more information about how the out-of-sample is used. |
int |
integer |
|
|
VF_BYGROUP |
BY variable values keyed by the corresponding variable names. The forecasts are generated for each unique combination of BY variables in the project. VF_BYGROUP is a list in R and is a dictionary in Python. |
dictionary |
list |
Number of BY variables |
|
VF_EVENTNAME |
Array of event names |
list |
atomic vector of character |
Number of events |
|
VF_HOLDOUT |
Number of data points used in the holdout sample. The user can set this number in the right pane of the Pipelines tab when this node is selected. See Assessing the Accuracy of the Models for more information about how the holdout period is used. |
int |
integer |
|
|
VF_HORIZON |
Start of the forecast horizon |
int |
integer |
|
|
VF_LEAD |
Length of forecast horizon for the project as specified in the project settings |
int |
integer |
|
|
VF_LENGTH |
Number of data points in the series including historical and horizon regions |
int |
integer |
|
|
VF_SEASONALITY |
Length of the seasonal cycle as defined on the Data tab or implied from the time ID interval |
int |
integer |
|
|
VF_TIME |
Array of the time ID values |
numpy.ndarray or list |
atomic vector of double |
VF_LENGTH |
|
VF_TIMEINTERVAL |
The time interval that is set for the time ID variable on the Data tab |
|
character |
|
|
VF_TIMENAME |
Name of the time ID variable as defined on the Data tab |
|
character |
|
|
VF_VARS |
Array of time series values keyed by the corresponding variable names. The VF_VARS variable is a dictionary in Python and is a list in R.
|
dictionary |
list |
2+Number of events and independent variables |
|
VF_XNAME |
Array of independent variable names, if there are any independent variables in the project |
list |
atomic vector of character |
Number of independent variables |
|
VF_Y |
Array of dependent variable values |
numpy.ndarray or list |
atomic vector of double |
VF_LENGTH |
|
VF_YNAME |
The name of the dependent variable |
|
character |
For Python code, you can use
pandas.to_datetime function to convert SAS date value,
SAS time value or SAS datetime value to pandas datetime. For example, the
following code converts the SAS date value df.DATE to a proper argument that
many Python modules are familiar with.
df = pandas.DataFrame({'DATE': DATE, 'AIR': AIR})
df.DATE = pandas.to_datetime(df.DATE, unit='D', origin=pandas.Timestamp('1960-01-01'))
In this code,
df is the pandas dataframe that contains time ID and
another variable, AIR. The options unit= and
origin= are defined according to the definition of SAS
date value (the number of days from January 1st, 1960.)
The following shows example code of a seasonal random walk model for the Distributed Open Source Code node using the shared variables.
for i in range(VF_SEASONALITY, VF_LENGTH):
if i > VF_LENGTH - VF_LEAD:
VF_PREDICT[i] = VF_Y[VF_LENGTH - VF_LEAD - VF_SEASONALITY]
else:
VF_PREDICT[i] = VF_Y[i - VF_SEASONALITY]
for (i in (VF_SEASONALITY+1):VF_LENGTH) {
if (i > VF_LENGTH - VF_LEAD) {
VF_PREDICT[i] <- VF_Y[VF_LENGTH - VF_LEAD - VF_SEASONALITY + 1]
}
else {
VF_PREDICT[i] <- VF_Y[i - VF_SEASONALITY]
}
}
The open source program can
alternatively use VF_VARS[VF_YNAME] (in Python) or
VF_VARS[[VF_YNAME]] (in R) in place of
VF_Y. They all refer to the dependent variable
array.
If your deployment's CAS server has more than one CAS worker, you can use the following example to see how different time series get distributed among the multiple workers of the CAS server.
cas casauto;
libname mycas cas;
options cassessopts=(caslib="Public");
data mycas.air50 (promote="yes");
set sashelp.air;
do bykey = 1 to 50;
output;
end;
run;
for i in range(VF_SEASONALITY, VF_LENGTH):
if i > VF_LENGTH - VF_LEAD:
VF_PREDICT[i] = VF_Y[VF_LENGTH - VF_LEAD - VF_SEASONALITY]
else:
VF_PREDICT[i] = VF_Y[i - VF_SEASONALITY]
import socket
print(socket.gethostname())
You can add the last two lines of the preceding code to any Python code that successfully generates the forecasts. The print() statement writes to the OUTOPENSRCLOG table the name of the worker node where a particular time series is processed.
In the far right column, Text of the external language program log, you can find the name of the node that processes the series.
The following tables are automatically generated when running this modeling node. The tables can be saved to another caslib by using the Save Data Node.
The following models are intended for time series that have been segmented based on patterns detected in the time series. They can be applied to other time series data, but the results might not be useful.
For example, the Retired Series modeling node is intended for time series that have not recorded any results in the final time periods. It does not produce any forecasts or measurements for statistics of fit.
The Non-seasonal Model node generates a list of appropriate non-seasonal model candidates for each time series, based on the model selection criteria that you choose. You can select between ESM, ARIMAX, and UCM models to be evaluated. After model selection, forecasts are generated for each time series using the selected model.
For ESM and UCM models, prebuilt options are available in PROC TSMODEL. For ARIMAX models, the search is performed over the models that have no seasonal AR, MA or differencing.
For a complete description of the settings that you can use, see Non-seasonal Model Settings.
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
This node is intended for time series that have been segmented based on patterns of inactivity as determined by the Demand Classification pipeline. It is not a good model for project data that has current active records. Retired Series does not support events.
This node does not generate forecasts. By default, all forecast values are set to missing. For information about changing this value, click for Retired Series in the Options pane.
This modeling node automatically generates these tables. You can use the Save Data Node if you need to save any of these tables.
You can also select the OUTFOR_HORIZON table. This table is optional. After the node is run, the OUTFOR_HORIZON table can be saved using the Save Data Node.
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
This node generates a list of seasonal model candidates based on the model selection criteria that you select and generates forecasts. You can select between ESM, ARIMAX, and UCM as candidate models. ESM and ARIMAX are selected by default. The model selection is limited to seasonal models. For ESM and UCM models, prebuilt options are available in PROC TSMODEL. For ARIMAX, model selection is performed between models that have either seasonal AR, MA, or differencing greater than zero.
Time series that do not fit the seasonal model are forecast using the best ESM candidates. Candidate models include simple, linear, damped trend, additive seasonal, Winters multiplicative, and Winters additive models.
For a complete description of the settings that you can use, see Seasonal Model Settings.
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
This node is intended to fit a pure regression model to the time series. This is accomplished by fitting an ARMA model with no intercept, no autoregressive (AR) component, and no moving average (MA) component. Omitting these components from an ARIMA model makes the model the equivalent of a regression model. For each time series, the node identifies the best regression model that can contain not only the independent variables and events that are available to use from the Data node, but also seasonal dummy variables and variables derived from the time index.
By default, the node creates seasonal dummy variables at the time interval of the input data or at a time interval that you specify. This option can be deselected. You can also select whether to include the observation index as an independent variable to capture linear effects, and to include the index squared and index cubed to capture higher order effects. If selected, these index-based features get included in the model only if they improve the model fit.
When this node is used in project data that has been segmented based on patterns determined by a Demand Classification pipeline, it is typically chosen as preferred modeling strategy for time series classified as INSEASON, which means activity occurs only during certain time periods. This model can also be a good fit for project data that consists of short time spans.
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
For a complete description of the settings that you can use, see Regression for Time Series Settings.
This node is intended for time series that are intermittent at the high-frequency level but seasonal at the accumulated low-frequency level. This modeling node forecasts high-frequency series using IDM and the low-frequency series are forecasted using one of the seasonal models that you select, such as ESM, ARIMA, or UCM. The results are then reconciled from the low-frequency level to the high-frequency level to yield the final forecasts.
The following table shows the time intervals used by this node. The project-level intervals on the left are specified on the time variable on the Data tab. These intervals are used to aggregate the high-frequency time series. As shown in the table, each high-frequency interval has a corresponding low-frequency interval, which is used to aggregate the low-frequency time series.
Any events used by this modeling node apply to the forecasts generated for the low-frequency interval.
Event support for this node was added in the 2025.01 release. Events are not supported for this node in projects imported from a deployment using a release prior to 2025.01. For projects imported from a prior release, you can add a new Temporal Aggregation Model to the pipeline and the new node supports events for the project. You need to make any modifications to the new node that you made to the previous Temporal Aggregation Model.
If the project is using a time interval that is not listed on the left, the low-frequency tables are not generated.
|
High-frequency interval (project level) |
Low-frequency interval |
|---|---|
|
Month |
Quarter |
|
Semimonth |
Month |
|
Ten-day |
Month |
|
Week |
Retail 4-4-5 month |
|
Day |
Week |
|
Hour |
Day |
|
Minute |
Hour |
|
Second |
Minute |
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
For a complete description of the settings that you can use, see Temporal Aggregation Model Settings.
If your site has a license for SAS Viya, these modeling nodes are available for use in the pipelines.
The Panel Series Neural Network modeling node provides forecasts by training a neural network based on user settings and develops a model to extract salient features across multiple time series. Neural networks consist of predictors (input variables), hidden layers, an output layer, and the connections between each of those items.
The Panel Series Neural Network modeling node is best suited for panels of time series with several interval independent variables. Independent variables for the neural network can be assigned in the Data tab or generated within the Feature Generation section of the node options. BY variables are automatically included as categorical inputs. This neural network cannot generate a model for the project without an independent variable.
Missing data in the historical data can cause observations to be discarded. In this case, the missing values are replaced with the median value for the time series to enable the neural networks to use more of the observations to fit the model.
If the trailing observations for any time series are missing, the start of the forecast period (horizon) is adjusted to prevent missing forecasts for the entire horizon for these time series.
For a description of the settings for this node, see Panel Series Neural Network Settings.
The Multistage Model provides a general framework that combines time series models and feature extraction techniques to build a hierarchy-based forecasting system in two stages.
|
This diagram shows the process flow of the Multistage Model node.
|
|
This modeling node is intended for a project with a defined hierarchy. If no BY variables are defined for the project, the forecast is generated using stage 1 time series model. For more information about hierarchies, see Defining the Hierarchy.
When working with the settings in the Options pane for Multistage Forecasting, consider any signals you might notice at different aggregationthe process of combining more than one time series to form a single series within the same time interval. For example, data can be combined into a total or an average. levels in the hierarchy. For example, in a retail scenario, time series signals such as trend or seasonalitya regular change in time series data values that occurs at the same point in each time cycle. might be best observed at a REGION or CATEGORY level. Setting this level as the stage 1 high level can better capture the time series signal using the stage 1 high-level time series forecast.
You might capture a stronger signal about how the sales respond to the price or promotionthe process of copying selected metadata and associated content within or between planned deployments of SAS software that could run different software releases. Methods of promotion include import and export processes, as well as explicit copies between two servers. This process is repeatable for a particular deployment. changes at the STORE or BRAND level. Setting this to the stage 1 low level allows the use of regression or neural network to model the price or promotion effect. At the lowest level, each STORE or SKU combination might have its own basic behavior that is not captured using the stage 1 models. These can be modeled separately in stage 2.
You can generate more a robust and reliable forecast by combining these elements:
This node is a pluggable model. You can edit the code to create your own modeling node. For more information, see Pluggable Modeling Nodes.
For more information about the individual settings for Multistage-forecasting, see Multistage Model Settings.
|

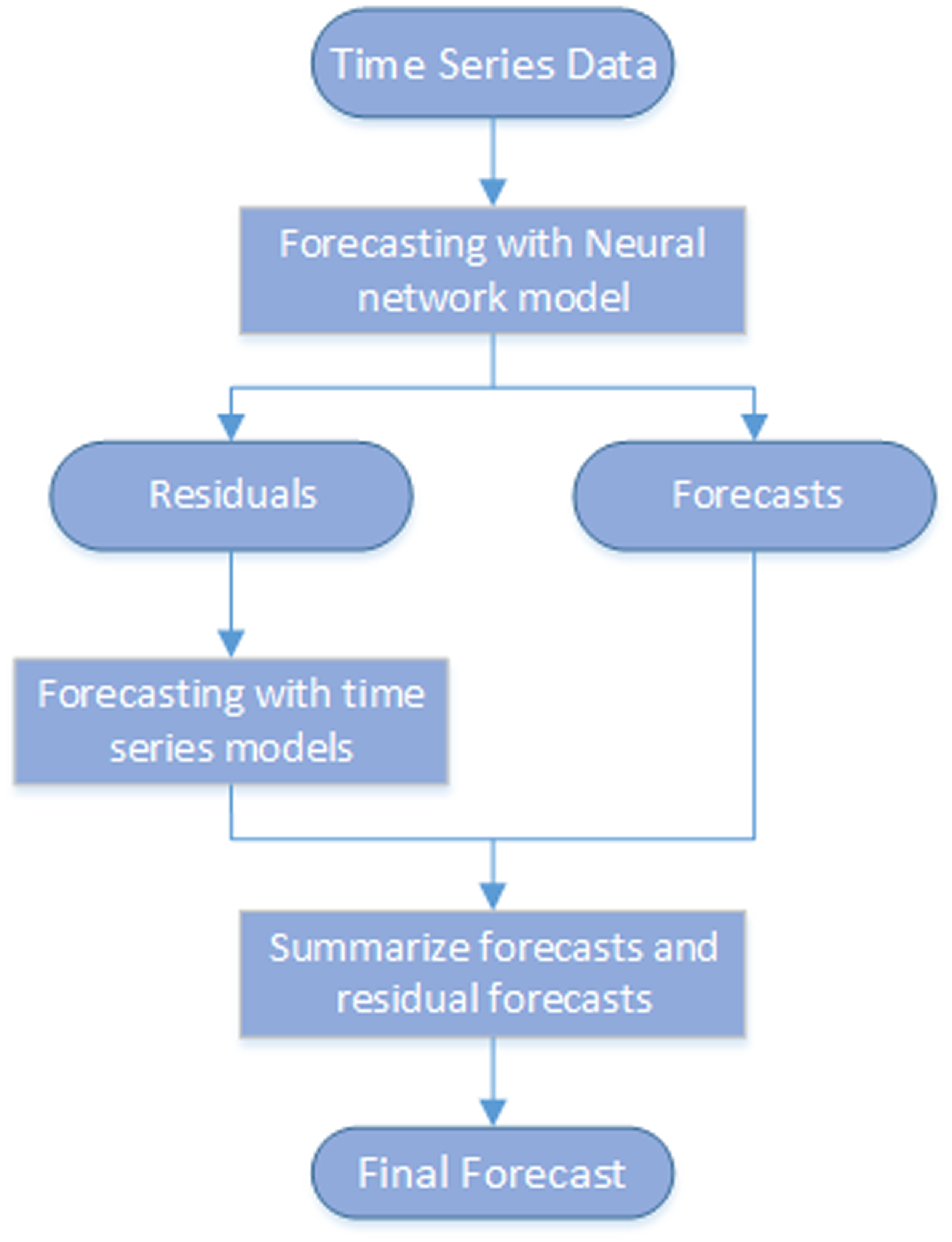

The stacked modeling node generates forecasts using stacked models that include a neural network model (NN) and a time series model (TS). This modeling node captures the nonlinear relationship between the dependent and independent variables as well as time series characteristics in the data, such as seasonality and trend. As this diagram shows, it models the time series in two steps:
The first and second steps run sequentially. The final forecasts are the sum of the forecasts from the neural network and the residual forecasts from the time series model. Note: Missing data in the historical data can cause observations to be discarded. In this case, the missing values are replaced with the median value for the time series to enable the neural networks to use more of the observations to fit the model. For more information about the settings for Stacked Model (NN + TS) Forecasting, see Stacked Model (NN + TS) Forecasting Settings. |
|
